Why Construction Order Holds Should Work Like Yellow Lights

Bectran logo for blog posts
Janine Aquino

Bectran Product Team

I

October 15, 2026

7 minutes to read

A red light stops every car at the intersection, whether the road ahead is clear or not. That’s how most ERPs treat a construction order that crosses a credit limit. The order stops, sits in a queue, and waits for someone on your receivables team to wave it through.

‍

A yellow light asks the driver to check conditions and decide whether to proceed with care or stop. A well-built credit hold policy gives your team the same signal. Low-risk orders get a green light and move automatically. Orders that need a second look get a yellow light, with clear criteria for what happens next. Only true risk gets a red light.

‍

For construction material suppliers, where materials have to reach job sites on schedule, the gap between a red light and a yellow light shows up directly in cash flow, project timelines, and customer relationships.

‍

Inefficient order hold processes can significantly impact a construction material supplier's financial health. A well-defined credit hold policy, specifically for the construction sector, ensures materials flow efficiently, mitigates financial risk, and strengthens customer relationships.

Why construction orders go on hold

Construction orders often go on hold for reasons beyond a simple credit limit breach. Exceeding a credit limit is a common trigger, especially in ERP systems that act as a "yellow light" or "wall". Other factors specific to the industry frequently cause delays. Unverified approval numbers for national accounts, such as those from a large hardware cooperative, also cause delays. Your receivables team needs a more direct approach than a binary 'approve or hold' decision to handle these requirements.

‍

The nature of construction projects, with custom-made goods and staggered deliveries over months, means a single large order can trigger a hold even if the immediate invoice risk for a particular shipment is low. For example, a $10,000 order for materials might involve ten deliveries over ten months. An ERP might flag the entire $10,000 against the credit limit, placing the order on hold, even if the current delivery is only $1,000 and the customer's payment history is solid. The ERP's flagging of the full amount forces your receivables team to manually override holds. Manual overrides consume time and divert staff from other tasks.

‍

Specific customer types, such as cash-in-advance (CIA) accounts or salesman sample orders, frequently trigger automatic holds that demand manual intervention to release. Without a specialized system, these varied triggers lead to a reactive process. Your receivables team manually reviews each hold, often relying on "gut instinct" rather than data-driven criteria. This manual process is slow, prone to error, and diverts staff from strategic financial management. It directly impacts project cash flow and adds to operational costs.

The financial impact of reactive order holds

The consequences of reactive order holds extend far beyond the receivables department, directly affecting a construction material supplier's profitability and operational efficiency. In 2024, slow payments in the U.S. construction industry produced a financial impact totaling $280 billion. The $280 billion impact underscores the severe working capital strain that inefficient processes can impose on businesses operating with tight margins.

‍

Delayed payments, often exacerbated by order holds, can add up to 14% of total construction costs. Suppliers experience eroded project profitability and tied-up capital that could be used for other investments, such as expanding inventory or upgrading equipment. Furthermore, 41% of B2B sales delays are attributed to inefficient order hold processes. Projects stall, and relationships with general contractors and subcontractors who depend on timely material delivery suffer.

‍

For a CFO, these impacts are direct. They translate into reduced cash flow, missed opportunities to take on additional projects, and a damaged company reputation. A system that merely stops an order at a credit limit, without a clear process for resolution, creates a bottleneck that directly undermines financial stability and growth. The lack of real-time visibility into hold reasons and resolution paths means time is lost, and the cost of capital tied up in receivables increases.

Building a proactive credit hold policy

Moving from a reactive "wall" to a proactive credit hold policy requires a structured approach that uses data and automation. A well-defined policy sets clear criteria for when an order should be held and when it can be automatically released. The policy's 'waterfall' logic involves a cascade of checks running quietly in the background on every order. Decisions are consistent and data-driven.

‍

Key criteria for auto-release eligibility can include credit limit ranges, order amount thresholds (e.g., orders under $250), and expected delivery date parameters (e.g., not auto-releasing if delivery is more than 30 days out). Customer exclusion lists allow for manual-only accounts and preserve human oversight where it is most needed for high-risk or strategic relationships. Low-risk orders flow through without intervention. High-risk orders receive manual review.

‍

Continuous monitoring of customer payment history, aging buckets, and last payment dates is important. The data allows for dynamic adjustments to credit limits and hold parameters. The monitoring identifies potential late payments before a hold becomes necessary. Your receivables team analyzes current release patterns. The analysis identifies candidates for auto-release. The team then has more time for complex cases. A proactive policy anticipates issues, rather than merely reacting to them.

Producer prices: construction materials (special index), PPI, index (1982=100), January 2024–August 2026. August 2026: 375.9, +10.1% vs. August 2025. Source: U.S. Bureau of Labor Statistics, series WPUSI012011. View the series at BLS

Beyond the credit limit: managing project-specific risk

Construction material suppliers face challenges that extend beyond traditional credit limit checks. The industry demands a policy that manages project-specific risk. The project-based nature of the industry often involves custom orders with staggered deliveries, where the total order value might exceed a credit limit, but the immediate risk for a single delivery is low. A sophisticated credit hold policy must account for this. Unnecessary holds disrupt project schedules.

‍

Consider alternatives to a full hold, such as a partial hold that allows orders under a reduced threshold while a balance is resolved. A partial hold keeps the customer operating, prevents exposure from growing excessively, and maintains supply chain continuity. Secured order arrangements, requiring cash-in-advance (CIA) or COD terms for new orders, provide security on new exposure without blocking revenue entirely.

‍

The policy should also address account-level holds for historically slow payers, even if they currently have no balance. Account-level holds for historically slow payers reduce the risk of future bad debt. All orders for such accounts receive manual review. By moving beyond a simple credit limit check, a construction supplier can tailor its hold policy to the specific, dynamic risks of project-based trade.

Integrating credit holds with your construction ERP

Most construction ERPs perform a basic credit limit check, stopping an order if the limit is exceeded. Stopped orders create a "wall" where they sit, awaiting manual intervention, without a defined process for resolution. The gap between the ERP's initial check and the need for dynamic credit decisioning is where a specialized receivables platform becomes important for optimizing cash flow.

‍

Integrating a credit hold management system with your construction ERP ensures a real-time, bidirectional data flow. Sales orders, hold statuses, and hold codes can flow from the ERP to the receivables platform, while release notifications update the ERP instantly. In construction, delays can quickly escalate project costs and timelines. The connection also provides the audit trail necessary for internal controls and compliance.

‍

For automated models to function, the receivables platform needs comprehensive data: customers, credit limits, open balances, aging reports, and payment history. Comprehensive data powers the "waterfall" logic. Automated releases then occur based on multiple criteria, not just a single credit limit. By sitting *beside* the ERP, a specialized platform enhances its capabilities. A specialized platform provides the detailed control and automation necessary for modern construction receivables without replacing the ERP's core project record functions.

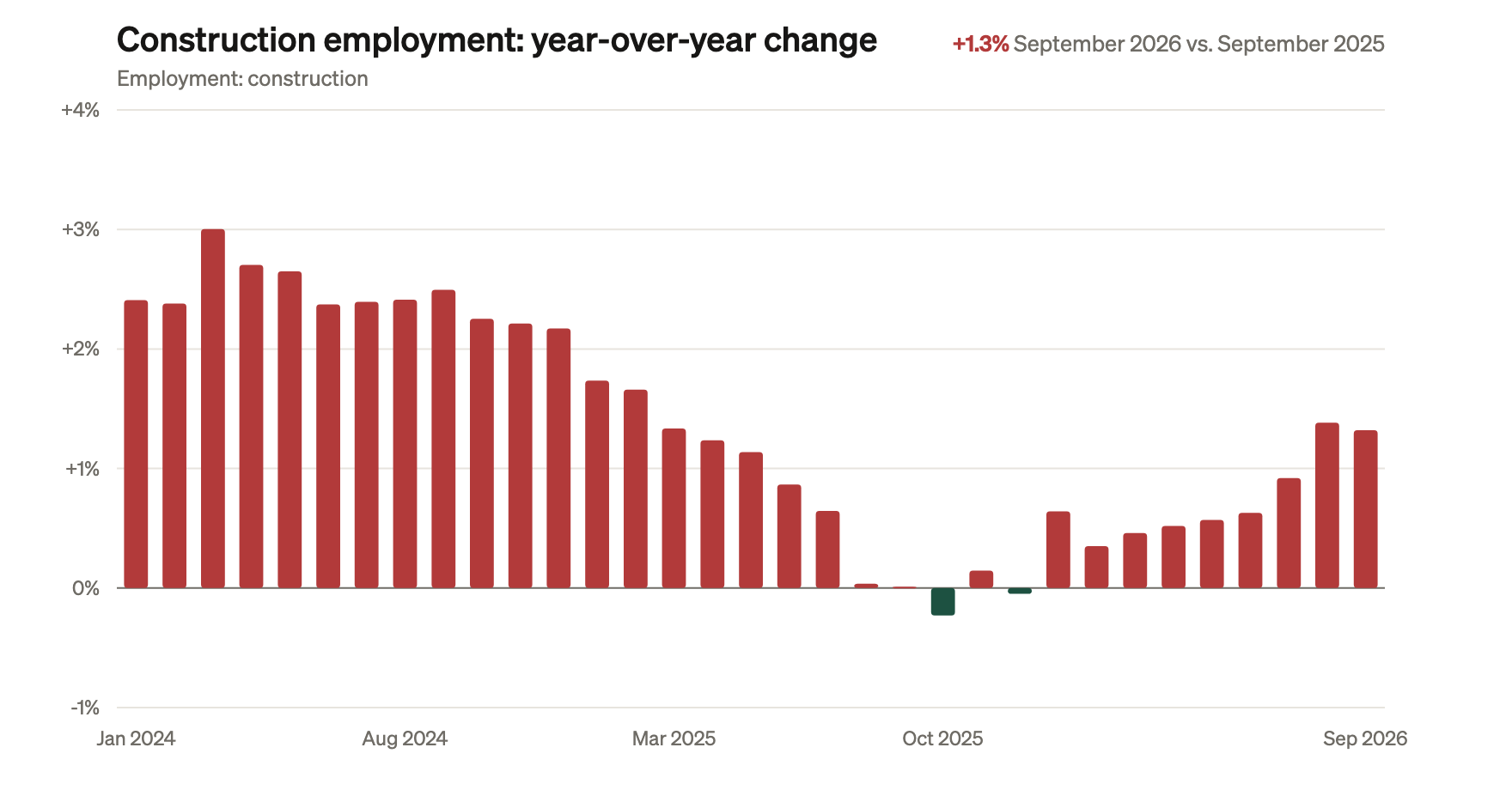

Employment: construction, year-over-year change by month, January 2024–September 2026. September 2026: +1.3% vs. September 2025. Source: U.S. Bureau of Labor Statistics, series CES2000000001. View the series at BLS

Optimize cash flow and project timelines

Bectran's receivables platform includes automated credit scoring and decisioning, multi-source bureau data aggregation, and configurable credit hold and approval workflows with routing. Bring your own credit hold policy to our team and settle on the right triggers for your portfolio before the next big project.

Frequently asked questions

What is a credit order hold in construction?

A credit order hold temporarily pauses a construction material order due to credit concerns, such as an outstanding balance or exceeding a credit limit. The hold's purpose is to prevent losses from non-payment before materials are shipped. Payment for goods supplied to projects is secured.

How do order holds impact construction project timelines?

Order holds can significantly delay project timelines by preventing the timely delivery of essential materials. The resulting project delays can lead to increased project costs, strained relationships with general contractors, and missed deadlines.

What is the difference between an order hold and an account hold?

An order hold applies to a specific sales order. The order's fulfillment pauses. An account hold freezes all activity for an entire customer account. New orders are blocked until the underlying financial issue is fully resolved.

How does Bectran automate credit hold decisions for construction suppliers?

Bectran automates credit hold decisions by applying a "waterfall" of configurable rules. The "waterfall" logic checks orders against criteria like credit limits, payment history, and delivery dates. Orders meeting the criteria are auto-released, while others are routed for review. The automation reduces manual effort.

Can Bectran integrate with existing construction ERP systems for order holds?

Yes, Bectran integrates with major construction ERPs like SAP, Oracle, and NetSuite via real-time API connections. Sales orders, hold statuses, and release notifications flow between systems. Bectran provides a unified view and automates updates.
